On Wednesday, July 30 the Town held its monthly project meeting with Elite Infrastructure to receive updates on the Lower Adams Creek Sewer Outfall project. Here is a summary of the work that has been completed since last month and work that is currently underway. The Town has been providing the information it has been given by contractors and engineers working on the project:
- Subcontractor Young Construction is diligently working to bore under Mt. Pleasant Road and has completed 25 linear feet as of July 28, 2025. This bore is approximately 75 linear feet in total, and completeion is anticipated in 10-15 working days.
- Subcontractor Palmetto is currently blasting rock on both sides of Mt. Pleasant Road, preparing for Elite Infrastructure to return and finish those sections.
- Elite Infrastructure is nearly finished with the installation of 8-inch line of the branches to the Summer Street Pump Station location and the Pasture Pump Station location (these pump stations will be decommissioned after the line is complete).
- Roughly 90% of what has been installed has been tested and has not encountered any issues so far.
- Catawba Lands Conservancy has reopened the portion of the Buffalo Creek Preserve Trail that had been closed on the north side of Adams Creek. Seeding of this area will take place toward the end of September.
- Elite Infrastructure is working on ordering gates to install where the easement meets Mt. Pleasant Road S.
Please call Town Hall at 704-436-9800 with questions.

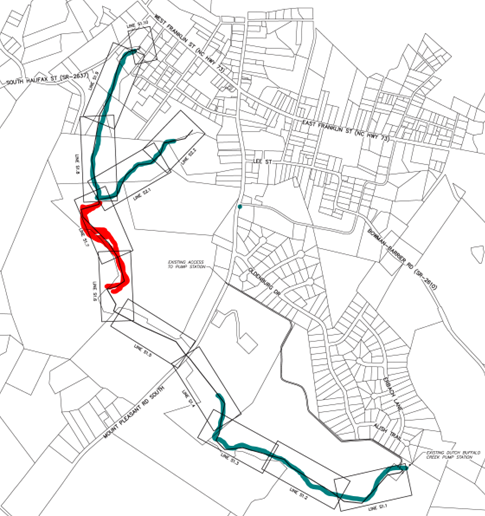

Map provided by contractor of sewer line that has been installed to date
Green-Installed
Red-Currently Being Installed
